South Street Water Main
Replacement, repair and maintenance of our water supply infrastructure, is critical to providing a reliable supply of clean drinking water to residents, providing water for fire protection, and preventing major disruptions and potential contamination issues that can arise from leaks or breaks in aging pipes. Portions of the Town’s water infrastructure are over 75 years old and are nearing the end of their useful life. Older infrastructure is prone to pipe deterioration, leading to frequent leaks and inefficiencies in water management. To ensure a continuous and safe water supply, the Department of Public Works (DPW) runs an ongoing rehabilitation program that includes the replacement, repair and maintenance of aging pipes. The scheduling of pipe replacements is prioritized based on several factors, including pipe condition, history of water breaks, and the adequacy of water flow to fire hydrants.
In 2023, the DPW submitted a funding request for the design and construction of water pipe replacements identified as priorities. Needham approved the funding, with one of the priority locations being the South Street Water Main. South Street, the first officially mapped street in the Town in 1771, is one of the longest streets at just over three miles, running from Great Plain Avenue to Charles River Street. The water main supplies the residents of South Street and multiple neighborhoods located along the street.
A portion of the water main between Chestnut Street and Charles River Street requires replacement. The project will install a new 16-inch diameter pipe along and under the road. To ensure uninterrupted water service during construction, a temporary bypass line will be installed. Residents will continue to have access to their homes throughout the project. Additionally, while the underground infrastructure is accessible and to minimize future disruption, where needed, concrete drain structures will be installed or repaired.
The project began in August 2024 and is expected to be completed by summer 2025. As with any long-term infrastructure project, construction is subject to weather and supply chain conditions. Work will continue through the fall, with a break during the winter. Construction is set to resume in the spring of 2025, with completion anticipated by mid-summer.
Replacing water mains that are old or in poor condition can reduce the risk of unexpected service interruptions and costly repairs.

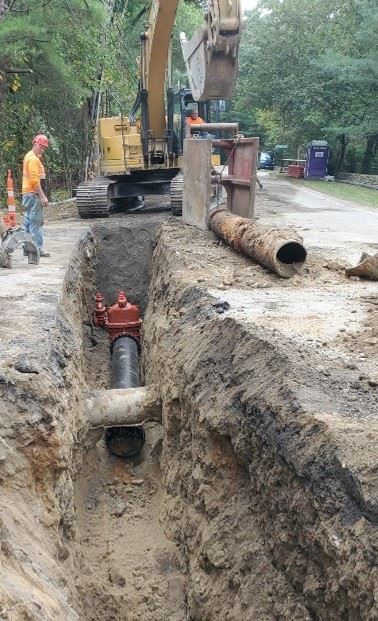

Project Progress
-

06282024_South Street_Construction Signage
-
07122024_South Street_Construction Start-Bypass
-
07122024_South Street_Detour Signage
-
07262024_South Street_Bypass Installation
-
07262024_South Street_Bypass Installation2
-
07262024_South Street_Bypass Installation
-
07262024_South Street_Bypass Installation2
-
07262024_South Street_Bypass Installation3
-
0802024_South Street_Water line connections to homes
-
08022024_South Street_Water line
-
08232024_South Street_Hydrant
-
08302024_South Street_New water line installation - Chestnut
-
08302024_South Street_New water line installation trench - Chestnut
-
08302024_South Street_South St at Chestnut excavation
-
09272024_South Street_South Street through the intersection at Farley Pond to the culvert
-
10042024_South Street_New water line 898-921 South St
-
10112024_South Street_New water line 921 to Marant Drive
-
10282024_South Street_New water line connections between Stonecrest and 898 South
-
11042024_South Street_Bypass removal Chestnut intersection
-
11042024_South Street_Loaming and seeding berm
-
11042024_South Street_New water line connections Stonecrest Chestnut Southwood and Farley Pond
-
11042024_South Street_Paving and patching
-
12202024_South Street_BMP installation
-
03282025_South Street_Bypass Installation
-
03282025_South Street_Bypass Preparation
-
03282025_South Street_Erosion Control Installation
-
03282025_South Street_Erosion Control Materials
-
04042025_South Street_Bypass Installation
-
04112025_South Street_Asphalt Cutting for Trench
-
04112025_South Street_Compacting and Tamping of Trench
-
04112025_South Street_Trenching
-
04182025_South Street_Closing up the New Water Line
-
04182025_South Street_Trench Box Placement
-
04182025_South Street_Water Main Connection
-
04252025_South Street_Excavation Around Large Tree Roots
-
04252025_South Street_Excavation for New Water Line
-
04252025_South Street_Excavation with Hydrant
-
04252025_South Street_Laying Pipe in Trench
-
04252025_South Street_Temporary Connection
-
05022025_South Street_Getting Ready to Saw Cut Asphalt for Excavation
-
05022025_South Street_Trench and Trench Box
-
05022025_South Street_Trenching and Trench Box
-
05022025_South Street_Trenching with Hydrant
-
05092025_South Street_Asphalt Cutting for Trench Preparation
-
05092025_South Street_Asphalt Surfacing over New Water Main
-
05092025_South Street_Excavation at Street Crossing
-
05092025_South Street_Excavation of Trench for New 16 inch Water Main
-
05092025_South Street_Excavation of Trench for New Water Line
-
05092025_South Street_Hydrant Installation
-
05092025_South Street_Traffic Cones Guiding Dome Over Bypass
-
05162025_South Street_Enclosing Water Line
-
05162025_South Street_New Water Line Installed
-
05162025_South Street_Trenching with Hydrant
-
05232025_South Street_Hydrant Installation
-
05232025_South Street_Paving Trench with New Water Line
-
05232025_South Street_Water Line Installation
-
05232025_South Street_White Bypass Line Next to Trench
-
06022025_South Street_Trench for Water Line
-
06022025_South Street_Water Line Placement
-
06032025_South Street_Trenching While Preventing Tree Damage
-
06042025_South Street_Waterline Placement with Mechanical Guide
-
06052025_South Street_Waterline at Hydrant Location
-
06062025_South Street_Trench Excavation of Water Main Line with Soil Capture Truck
-
06102025_South Street_Main Waterline Valve Installation
-
06102025_South Street_Waterline Flushing
-
06122025_South Street_Installation of a Structure Base
-
06122025_South Street_Waterline Connection
-
06122025_South Street_Waterline Installation
-
06162025_South Street_Tapping Main Waterline for Connection
-
06172025_South Street_Crossing South Street for Residential Service Connection
-
06172025_South Street_Dechlorinating of New Water Main after Sanitizing
-
06182025_South Street_Residential Water Service Connection
-
06182025_South Street_Water Sampling for Testing
-
06242025_South Street_Moving of Bypass Piping Sections
-
06252025_South Street_Hydrant Water Supply of Bypass Line
-
06262025_South Street_Pavement Patch Over Bypass Line
-
06272025_South Street_Residential Water Service Connection
-
07142025_South Street_Connecting and Disconnecting Water Services
-
07142025_South Street_Excavation for Waterline Installation
-
07172025_South Street_Water Main Placement into Trench
-
07182025_South Street_Excavation for Water Main Replacement
-
07212025_South Street_Trench Excavation and Removal of Old Piping
-
07222025_South Street_Excavation and Removal of Old Piping
-
07222025_South Street_Excavation in Preparation for Replacement Water Main Piping
-
07222025_South Street_Gate Valve Assembly Straddling Water Pipe
-
07222025_South Street_Water Main Placement in Trench with Alignment and Connection
-
07232025_South Street_Excavation for Replacement Water Main Piping
-
07242025_South Street_Excavation for Replacement Water Main Piping
-
07252025_South Street_Milling Work for Trenching
- 1 06282024_South Street_Construction Signage
- 2 07122024_South Street_Construction Start-Bypass
- 3 07122024_South Street_Detour Signage
- 4 07262024_South Street_Bypass Installation
- 5 07262024_South Street_Bypass Installation2
- 6 07262024_South Street_Bypass Installation
- 7 07262024_South Street_Bypass Installation2
- 8 07262024_South Street_Bypass Installation3
- 9 0802024_South Street_Water line connections to homes
- 10 08022024_South Street_Water line
- 11 08232024_South Street_Hydrant
- 12 08302024_South Street_New water line installation - Chestnut
- 13 08302024_South Street_New water line installation trench - Chestnut
- 14 08302024_South Street_South St at Chestnut excavation
- 15 09272024_South Street_South Street through the intersection at Farley Pond to the culvert
- 16 10042024_South Street_New water line 898-921 South St
- 17 10112024_South Street_New water line 921 to Marant Drive
- 18 10282024_South Street_New water line connections between Stonecrest and 898 South
- 19 11042024_South Street_Bypass removal Chestnut intersection
- 20 11042024_South Street_Loaming and seeding berm
- 21 11042024_South Street_New water line connections Stonecrest Chestnut Southwood and Farley Pond
- 22 11042024_South Street_Paving and patching
- 23 12202024_South Street_BMP installation
- 24 03282025_South Street_Bypass Installation
- 25 03282025_South Street_Bypass Preparation
- 26 03282025_South Street_Erosion Control Installation
- 27 03282025_South Street_Erosion Control Materials
- 28 04042025_South Street_Bypass Installation
- 29 04112025_South Street_Asphalt Cutting for Trench
- 30 04112025_South Street_Compacting and Tamping of Trench
- 31 04112025_South Street_Trenching
- 32 04182025_South Street_Closing up the New Water Line
- 33 04182025_South Street_Trench Box Placement
- 34 04182025_South Street_Water Main Connection
- 35 04252025_South Street_Excavation Around Large Tree Roots
- 36 04252025_South Street_Excavation for New Water Line
- 37 04252025_South Street_Excavation with Hydrant
- 38 04252025_South Street_Laying Pipe in Trench
- 39 04252025_South Street_Temporary Connection
- 40 05022025_South Street_Getting Ready to Saw Cut Asphalt for Excavation
- 41 05022025_South Street_Trench and Trench Box
- 42 05022025_South Street_Trenching and Trench Box
- 43 05022025_South Street_Trenching with Hydrant
- 44 05092025_South Street_Asphalt Cutting for Trench Preparation
- 45 05092025_South Street_Asphalt Surfacing over New Water Main
- 46 05092025_South Street_Excavation at Street Crossing
- 47 05092025_South Street_Excavation of Trench for New 16 inch Water Main
- 48 05092025_South Street_Excavation of Trench for New Water Line
- 49 05092025_South Street_Hydrant Installation
- 50 05092025_South Street_Traffic Cones Guiding Dome Over Bypass
- 51 05162025_South Street_Enclosing Water Line
- 52 05162025_South Street_New Water Line Installed
- 53 05162025_South Street_Trenching with Hydrant
- 54 05232025_South Street_Hydrant Installation
- 55 05232025_South Street_Paving Trench with New Water Line
- 56 05232025_South Street_Water Line Installation
- 57 05232025_South Street_White Bypass Line Next to Trench
- 58 06022025_South Street_Trench for Water Line
- 59 06022025_South Street_Water Line Placement
- 60 06032025_South Street_Trenching While Preventing Tree Damage
- 61 06042025_South Street_Waterline Placement with Mechanical Guide
- 62 06052025_South Street_Waterline at Hydrant Location
- 63 06062025_South Street_Trench Excavation of Water Main Line with Soil Capture Truck
- 64 06102025_South Street_Main Waterline Valve Installation
- 65 06102025_South Street_Waterline Flushing
- 66 06122025_South Street_Installation of a Structure Base
- 67 06122025_South Street_Waterline Connection
- 68 06122025_South Street_Waterline Installation
- 69 06162025_South Street_Tapping Main Waterline for Connection
- 70 06172025_South Street_Crossing South Street for Residential Service Connection
- 71 06172025_South Street_Dechlorinating of New Water Main after Sanitizing
- 72 06182025_South Street_Residential Water Service Connection
- 73 06182025_South Street_Water Sampling for Testing
- 74 06242025_South Street_Moving of Bypass Piping Sections
- 75 06252025_South Street_Hydrant Water Supply of Bypass Line
- 76 06262025_South Street_Pavement Patch Over Bypass Line
- 77 06272025_South Street_Residential Water Service Connection
- 78 07142025_South Street_Connecting and Disconnecting Water Services
- 79 07142025_South Street_Excavation for Waterline Installation
- 80 07172025_South Street_Water Main Placement into Trench
- 81 07182025_South Street_Excavation for Water Main Replacement
- 82 07212025_South Street_Trench Excavation and Removal of Old Piping
- 83 07222025_South Street_Excavation and Removal of Old Piping
- 84 07222025_South Street_Excavation in Preparation for Replacement Water Main Piping
- 85 07222025_South Street_Gate Valve Assembly Straddling Water Pipe
- 86 07222025_South Street_Water Main Placement in Trench with Alignment and Connection
- 87 07232025_South Street_Excavation for Replacement Water Main Piping
- 88 07242025_South Street_Excavation for Replacement Water Main Piping
- 89 07252025_South Street_Milling Work for Trenching
The contractor mobilized and began construction of the bypass water line, initiating work at Chestnut Street. Erosion control measures were completed early in the season, and both abutters and nearby residents were notified of the project, including details of a permanent traffic detour.
Work advanced with the installation of the bypass water line extending from Stonecrest Drive to Farley Pond Lane, and temporary road closures were put in place to accommodate sewer extension work to a private development. A temporary bypass line was installed and was successfully chlorinated following installation. Water quality tests were completed and passed, confirming the bypass system was safe for use.
Connections were made from individual house lines and lateral lines to the bypass, and resident tie-ins continued throughout the season. Later in the summer, the contractor connected lateral lines at Chestnut Street and Southwood Lane to the bypass and deactivated a section of the existing water main.
Traffic adjustments were implemented to support ongoing work, with South Street operating as one-way westbound between High Rock and Chestnut Street and limited local access maintained from the east. Daily road closures generally began in the morning and reopened in the afternoon, with schedules adjusted for weather and school transportation needs. By season’s end, water construction was completed between Chestnut Street and Marant Drive, excavation began at the South Street and Chestnut Street intersection for the new water line, and a gate valve was installed and the trench backfilled.
During the fall season, work began with the installation of the water main at the south side of the Chestnut Street intersection, as well as the placement of a 16-inch main, including the installation of fire hydrants. The contractor steadily advanced down South Street, extending the water line past Stonefield, Southwood, and beyond Farley Pond. Additional hydrants and a catch basin were installed near the Chestnut Street and Farley Pond areas.
The new water line continued through the Farley Pond intersection to the culvert. The bypass system was connected, followed by pressure testing and chlorination of the new main. As construction continued, water samples were collected to ensure quality standards were met, and trench paving began.
The project also included the connection of Stonecrest, Chestnut, Southwood, Farley Pond, and remaining house services to the new main. Once the final lateral was connected, the contractor began removing the bypass system. Restoration work included loaming and seeding the berm between Chestnut Street, Stonecrest, and Southwood. The contractor then began preparations for the installation of best management practices (BMPs).
Later in the season, an R-Tank was installed, along with a sluice and manhole. As winter approached, minor sitework was completed, and the contractor demobilized with plans to resume construction in the spring, weather permitting.
K&K Excavation resumed work with the installation of erosion control measures along South Street between Marant Drive and Charles River Street. They assembled and completed a bypass water line along the northerly side of South Street, extending from Marant Drive to Crestview Road. Following chlorination and successful sampling of the bypass, crews began test pitting to locate the existing water main, saw cutting the trench, and preparing the work area by stripping loam.
Service connections were made to Burr Drive and several properties along South Street. The old water main was shut down and drained, and installation of the new main began, progressing steadily toward Burr Drive and beyond. The new water main was installed in segments with multiple hydrants and water services connected along the way. A 110-foot section of drainpipe was also replaced.
In addition to main line installation, a second crew focused on restoration, spreading loam and seed in previously disturbed areas and trimming overhanging branches to maintain equipment access. Bypass infrastructure was also extended along Charles River Street, including through its intersection with South Street. Several trenches were paved, and sections of the new water main were pressure tested and prepared for chlorination.
Throughout the summer of 2025, steady progress was made on the installation and activation of the new water main along South Street. The new main was extended from Marant Drive to Charles River Street, with sections activated and pressure tested in stages. Several hydrants, gate valves, and laterals were installed, and numerous service connections were completed, transitioning homes from the temporary bypass system to the new main. Chlorination, flushing, and de-chlorination procedures were conducted as required, and leak testing led to minor repairs and adjustments. Portions of the bypass were relocated as work progressed westward. Final trench paving was completed in various segments, and the project advanced toward completion with continued installation of hydrants, laterals, and main connections.
